Kilo geographic site and campus context
Ascendent
ASCENDENT Kilo · Kerr County
DOC · KILO-SA
REV · 3.1 · 2026.09.16
CLASS · CONFIDENTIAL — SUBJECT TO CONTRACT
KILO · SITE ASSESSMENT

Kilo.

Your campus-scale AI site in Kerr County: surveyed land, executed LCRA and PEC instruments, and a 2,100 MW / 345 kV study path. Firm capacity is the next utility workstream — not a reason to wait on the conversation.

Kerrville, Kerr County, TexasFor tenants, labs, and campus partners
Kilo surveyed tract on the Kerr County map
KILO CAMPUS MAP · KERR COUNTY TRACT · 2026-09-15
Surveyed tract
3,979.63 ac
Title-survey tract. Acreage scopes stay separate on purpose.
Study basis
2,100 MW / 345 kV
Study basis on executed instruments. Firm capacity is the next workstream.
Development instruments
LCRA LLI-2421 + PEC FEA
LCRA study + PEC facility agreement. Construction follows the usual utility gates.
Indicative BTM
1,105 MW
Phase 1 generation plan for campus design. Planning figure, not installed kit.
PROJECT KILOSITE ASSESSMENT01 / 25

Kerr County, Texas · Aerial imagery + source terrain (2× relief). Source ranch outline and conceptual campus zones; not a survey or as-built record. Imagery: Esri, Vantor, Earthstar Geographics & GIS User Community.

Ascendent
ASCENDENT
00 · CONTENTS
KILO-SA

Four chapters. One campus conversation.

How to walk the site with your team.

READING RULE
Read this as a campus brief for your team. Confirmed and submitted are file statuses. Scores, workstream counts, and claims come from different layers — we keep them labeled so you can use each on its own terms.
P2Power & utilitiesThe 2,100 MW / 345 kV path, on-site generation, water and fiber workstreams.
P3Campus viewsThe map, the campus concept, and the stored readiness snapshot.
P4Working with youThe workstreams we close with your load, cooling, and network brief.
ASource annexUnderlying claims, notes, and the next action for each domain.
Source: [1] · [3]
SITE ASSESSMENTCONTENTS02 / 25
Kerr County aerial terrain and conceptual campus context
Ascendent
ASCENDENT Kilo · Kerr County
DOC · KILO-SA
REV · 3.1 · 2026.09.16
CLASS · CONFIDENTIAL — SUBJECT TO CONTRACT
[P1]

Your campus.

Land, access, and the ground you would take.

You start with a recorded tract, access on the instruments, slope-screened hall area, and a Phase I with no recognized environmental conditions on its stated scope.

PROJECT KILOSITE ASSESSMENT03 / 25
Site context · aerial imagery / source terrain · conceptual overlays, not a survey. Imagery: Esri, Vantor, Earthstar Geographics & GIS User Community.
Ascendent
ASCENDENT
P1 · §1 SITE IDENTITY
KILO-SA

This is Kilo, in Kerr County.

The campus card your team will brief against.

This campus sits in Kerrville, Kerr County, on ERCOT West at 345 kV. The hall-planning card is 4 × 500 MW (2,000 MW). The utility study request is 2,100 MW. Both are planning figures — the workstream is to make them real against your load.

Site
KILO
Campus name.
Place
Kerrville, Kerr County, Texas
Campus name.
Interconnect note
345 kV · ERCOT West
ERCOT West. Interconnect path is in the utility file.
Hall planning card
4 × 500 MW / 2,000 MW
Campus IT-load concept. Separate from the 2,100 MW study basis.
SITE ASSESSMENTP1 — CAMPUS04 / 25
Ascendent
ASCENDENT
P1 · §2 LAND TITLE
KILO-SA

You have a deed and a surveyed campus tract.

Land control you can brief. Three acreage scopes stay separate.

A recorded deed and title survey give you a campus you can plan. The survey is 3,979.63 acres. Deed, Phase I, and appraisal used different scopes — we keep them labeled. Title-close work is a tenant workstream, not a missing campus.

  • Deed to Blue Fox Development, LLC. Authored status: confirmed. [land-01] [L1]
  • Deed acreage: 3,980.63 gross acres less a 1.00-acre exception. Kerr County Document 24-02602. [land-02] [L1]
  • Title survey: 3,979.63-acre tract, with record access, telephone, and water-related easements. [land-03] [L1]
  • Phase I ESA scope: 24 adjoining parcels totaling approximately 4,005.86 acres. Different scope. [land-04] [L1]
  • Appraisal used a 4,500-acre premise — a third scope. We do not combine it with the survey, and we do not lead with appraisal numbers. [land-m02] [finance-01]
Survey
3,979.63 ac
Governing surveyed figure for campus scale.
Deed
3,980.63 ac − 1.00 ac
Gross less exception. Recorded 8 May 2024.
Phase I scope
4,005.86 ac
24 parcels. Environmental scope, not the survey.
NEXT GATE
Next with your counsel: current title commitment, Schedule B, minerals and liens, and a parcel crosswalk across deed, survey, Phase I, and tax.
Source: land-01 · land-02 · land-03
SITE ASSESSMENTP1 — CAMPUS05 / 25
Ascendent
ASCENDENT
P1 · §3 ACCESS, TERRAIN, LAYOUT
KILO-SA

Access is on the instruments. There is room for halls.

Recorded access, plus slope-screened area for campus layout.

You have recorded access and conceptual campus geometry. Slope screens are a planning start — we engineer pads, drainage, and the master plan as the next site workstream.

  • YO Ranch Road strip: 60 ft wide, 16.33 acres. Authored status: confirmed. [access-01] [L1]
  • Title survey: 60-foot private-access easement. Authored status: confirmed. [access-02] [L1]
  • Conceptual geometry: five KML polygons, six-hall schematic, slope maps. Authored status: submitted. [access-03] [L1]
  • Slope screening: 3,514.1 acres under a less-than-10-percent criterion; 3,109.4 acres under less-than-5-percent, avoiding mapped FEMA and wetland areas. Submitted. [geo-02] [L1]
<10% slope screen
3,514.1 ac
Screening map, submitted. Not a graded pad.
<5% slope screen
3,109.4 ac
Screening map, submitted. Avoids mapped FEMA and wetlands in the source maps.
NEXT GATE
Reconcile legal and physical access, validate heavy-haul and emergency circulation, then issue an engineered master plan for grading, drainage, roads, halls, and utility corridors.
SITE ASSESSMENTP1 — CAMPUS06 / 25
AscendentASCENDENT
KILO-SA · REV 3.1 · 2026.09.16
CONFIDENTIAL — SUBJECT TO CONTRACT
P1 · THE PLACE

See the ranch. See the campus.

Campus on the landform

Kilo campus overview in Kerr County
Ranch outline and planned campus zones over real aerial context. This is the ground you would take.

Closer on the planned halls

Kilo property and campus context
Same land, closer in. Planning zones — not graded pads or as-built halls.
Ascendent
ASCENDENT
P1 · §4 ENVIRONMENTAL
KILO-SA

Phase I is done on the stated scope.

No recognized environmental conditions on the Phase I scope. Field and design studies are the next site workstream.

The January 2026 Phase I reported no recognized environmental conditions on its 4,005.86-acre, 24-parcel scope. Targeted geotech, karst, and layout studies are the next workstream as halls land.

  • Phase I ESA: no recognized environmental conditions on the stated 4,005.86-acre, 24-parcel scope. Confirmed. [geo-01] [L1]
  • Groundwater-prospecting report describes the surveyed area as primarily Edwards Limestone Formation. Submitted. [geo-03] [L1]
  • Next design gate: targeted geotechnical and karst investigation for halls, power facilities, roads, substations, and corridors. [geo-m01] [gap-environmental-stage]
  • Also remaining as layout matures: wetlands and waters, parcel flood and drainage, species, cultural, air, and noise work. [geo-m02] [L1]
Phase I result
No RECs
ASTM E1527-21, January 2026, stated scope only.
Phase I area
4,005.86 ac / 24 parcels
Environmental scope, not the 3,979.63-acre survey.
Source: geo-01 · geo-03
SITE ASSESSMENTP1 — CAMPUS08 / 25
Kerr County aerial terrain and conceptual campus context
Ascendent
ASCENDENT Kilo · Kerr County
DOC · KILO-SA
REV · 3.1 · 2026.09.16
CLASS · CONFIDENTIAL — SUBJECT TO CONTRACT
[P2]

How power gets to your halls.

Grid path, on-site generation, water, and fiber.

You already have executed study and facility instruments and a first-cut engineering path. The 2,100 MW / 345 kV figure is the study basis. We close supply, firm capacity, and energization with your load case.

PROJECT KILOSITE ASSESSMENT09 / 25
Site context · aerial imagery / source terrain · conceptual overlays, not a survey. Imagery: Esri, Vantor, Earthstar Geographics & GIS User Community.

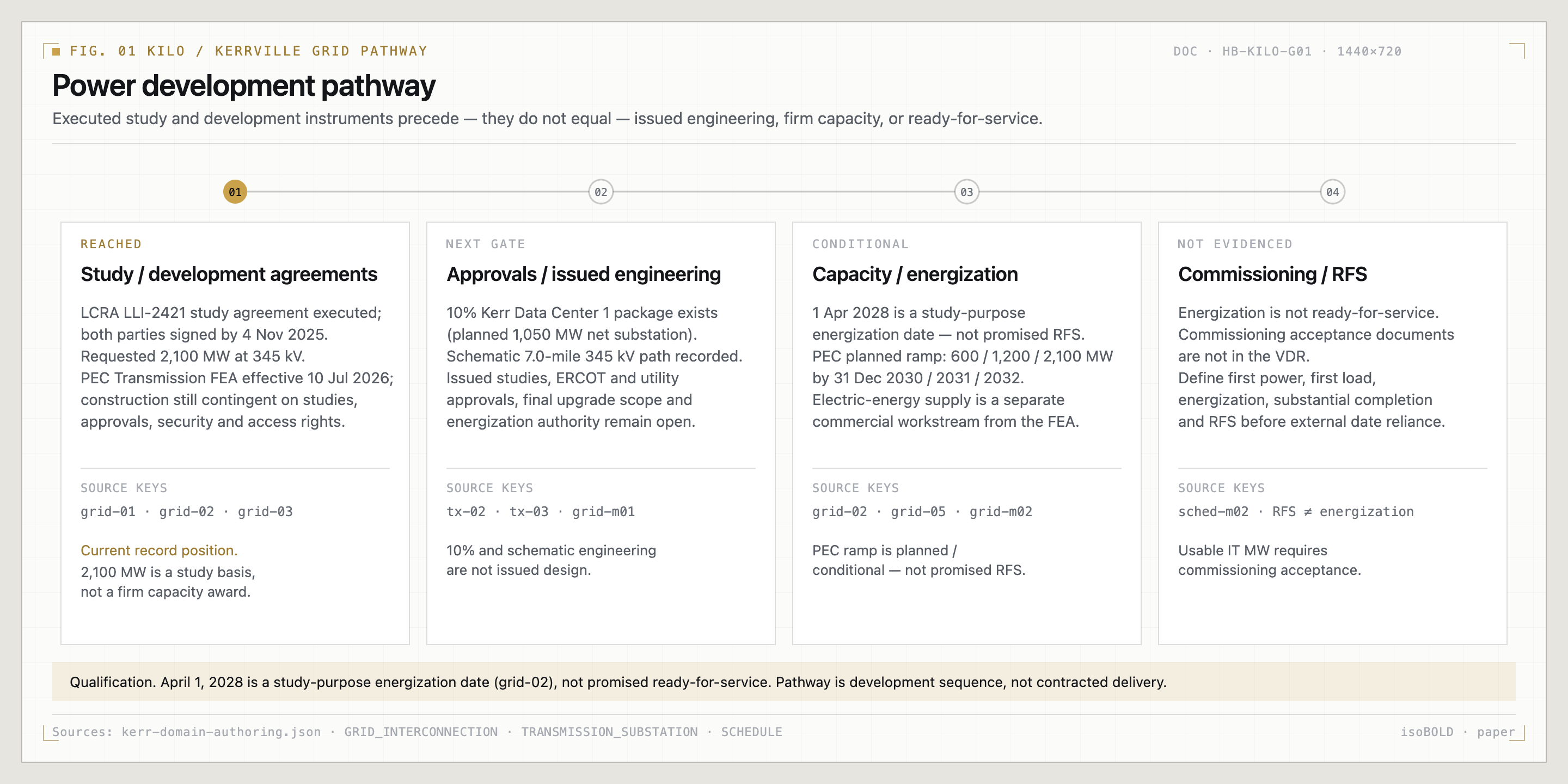

Power development pathway
KILO-SA · Power development pathwaySource [1] · Study and planning path. Firm capacity and ready-for-service follow the utility workstream.10 / 25
Ascendent
ASCENDENT
P2 · §2 TRANSMISSION / SUBSTATION
KILO-SA

Two proposed points on LCRA 345 kV.

A 10% substation package and a schematic corridor. Issued design is the next engineering workstream.

The LCRA study names proposed points on Big Hill–Kendall 345 kV. A 10% substation package and a schematic 7-mile corridor are already in file. Rights, the I-10 crossing, and issued design are the work we do next.

  • Two proposed POIs on LCRA-owned Big Hill–Kendall 345 kV circuits. Confirmed. [tx-01] [L1]
  • 10% package: preliminary 345/34.5 kV single-line, general arrangement, site plan, and equipment for a planned 1,050 MW net substation. Submitted. [tx-02] [L1]
  • Schematic plan: proposed 7.0-mile 345 kV path, one I-10 crossing, a midpoint PEC tie, and an on-site switchyard. Submitted schematic, not surveyed ROW. [tx-03] [L1]
Proposed POI
Big Hill–Kendall 345 kV
Two proposed points in the LCRA study.
Substation package
1,050 MW net · 10%
Preliminary. Not issued design.
Schematic path
7.0 mi 345 kV
Authored schematic. Not a surveyed easement package.
NEXT GATE
Survey the route, secure rights and I-10 crossing approval, reconcile endpoints, and complete utility-approved design including final one-line, protection, grounding, and structure spotting.
Source: tx-01 · tx-02 · tx-03
SITE ASSESSMENTP2 — INFRASTRUCTURE11 / 25
Ascendent
ASCENDENT
P2 · §3 BTM GENERATION AND GAS
KILO-SA

A 1,105 MW on-site generation path.

A Phase 1 generation path you can design against. Binding fuel is the next commercial workstream.

You have a gas origination path and a preliminary Phase 1 plan: 442 CAT G3520K engines totaling 1,105 MW. Binding fuel, the lateral, and plant commitments are the work we close with you. Planning figures are not installed kit.

  • Kinder Morgan proposed firm transportation of up to 215,000 MMBtu/d to a new Kerr County delivery point for a 10-year term after meter in-service. Submitted. Not a binding contract. [gas-01] [L1]
  • Proposal contemplates a new lateral and interconnect, with receipt and delivery points still to be determined. Submitted. [gas-02] [L1]
  • Preliminary Phase 1 schedule: 442 CAT G3520K engines totaling 1,105 MW through July 2029, deliveries April 2027 through July 2029. Submitted. [gas-03] [equip-02]
  • Supporting Ascendant Energy JSON, kept separate: 191 CAT G3520K engines, 477.5 MW nameplate. Not interchangeable with the 442 / 1,105 MW schedule. [L5]
Authored Phase 1 BTM
442 engines / 1,105 MW
Preliminary Gantt. Planning, not installed.
Supporting JSON
191 engines / 477.5 MW
Ascendant Energy gen-mix file. Separate record.
KM proposal
≤215,000 MMBtu/d
Discussion-stage proposal. Points TBD. Not binding fuel.
Source: gas-01 · gas-03 · [5]
SITE ASSESSMENTP2 — INFRASTRUCTURE12 / 25
Ascendent
ASCENDENT
P2 · UTILITIES & PERMITTING
KILO-SA

Water, fiber, and permits already have a path.

The file already names the next wells, the nearby backbone, and the agency path.

WORKSTREAMSOURCE BASISNEXT GATE

Water

Well-quality testing and a 24-location prospecting program define a source-development pathway.

Drill and pump-test priority targets; establish rights/permits and the phased water/wastewater balance.

Fiber

The Kerr Summary reports a 48-strand LCRA backbone about 0.11 mile / 600 feet from the northern boundary.

Confirm allocation or IRU terms, surveyed laterals, latency and physically diverse end-to-end routes.

Permitting

Rural land-use context and a planned TCEQ air-permit workstream identify the agency pathway.

Maintain a complete permit register, current application status and agency correspondence tied to the schedule.

Well tests and interpreted groundwater are a source program, not a supply guarantee. Backbone adjacency is the start of a fiber contract. Planned applications still have to be filed and issued — that is the permitting workstream. Source [1] · water-01/03, fiber-01, permit-01/02.

PROJECT KILO · SITE ASSESSMENTP2 · DEVELOPMENT PATHWAYS13 / 25
Grid and BTM planning tracks
KILO-SA · Grid and BTM planning tracksSource [1] · Study and planning path. Firm capacity and ready-for-service follow the utility workstream.14 / 25
Ascendent
ASCENDENT Kilo · Kerr County
DOC · KILO-SA
REV · 3.1 · 2026.09.16
CLASS · CONFIDENTIAL — SUBJECT TO CONTRACT
[P3]

See the campus.

Map, concept, and readiness.

These views put the tract, the campus concept, and the stored readiness snapshot in front of your team.

PROJECT KILOSITE ASSESSMENT15 / 25
Ascendent
ASCENDENT
P3 · §1 PLATFORM MAP
KILO-SA

Your tract, on the map.

Start here when you want to see the land.

Kilo platform map
KILO · KERR COUNTY, TEXAS · CAMPUS MAP
Overlays are platform representations, not a survey replacement. Basemap: Esri World Imagery.

This is the campus on the Kerr County map. Use it to brief land, grid, and layout — then go to the survey for legal boundary.

  • Campus claims and the stored readiness snapshot sit on this map. [L4]
  • Use the map to walk land, grid, and utilities. The survey remains the legal tract. [land-03] [L1]
Source: [4] · land-03
SITE ASSESSMENTP3 · CAMPUS MAP16 / 25
Ascendent
ASCENDENT
P3 · CAMPUS FILE
KILO-SA

Twelve domains. One campus file.

What is in hand, and the next action in each domain.

Kilo campus concept
Campus concept for hall planning. The twelve-domain file sits behind this view.
12campus domains
39facts in file
24working notes
12named workstreams

Confirmed and submitted are file statuses. Use the annex when you want the citation behind a sentence.

Source [1] · Complete authored domain record

PROJECT KILO · SITE ASSESSMENTP3 · CAMPUS FILE17 / 25
AscendentASCENDENT
KILO-SA · REV 3.1 · 2026.09.16
CONFIDENTIAL — SUBJECT TO CONTRACT
P3 · CAMPUS CONCEPT

Halls on the landform.

Campus concept

Architectural definition
Campus concept for hall planning. Editorial light and materials. Not an as-built photo.

The Kerr County setting

Landform and atmosphere
The landform your campus sits on. Vertically exaggerated for reading. Not a grading plan.
AscendentASCENDENT
KILO-SA · REV 3.1 · 2026.09.16
CONFIDENTIAL — SUBJECT TO CONTRACT
P3 · THE PLACE AT DUSK

The setting your campus occupies.

Campus at dusk

Kilo landscape at dusk
The Kerr County setting. Concept atmosphere for the campus story.

The landform

Kerr County terrain
Planning visualization of the land your halls would sit on. Not a survey or an approved interconnect point.
Ascendent
ASCENDENT
P3 · §4 SCORECARD
KILO-SA

Campus readiness, shown in full.

A planning snapshot for this campus — not a ranking of other sites.

85
VIABLE
2026-09-02
Stored campus snapshot.
Planning score for this site.
Not a market ranking.
File mix (different basis):
17 in hand / 30 in motion / 12 next

The stored campus snapshot is 85 / Viable, dated 2 September 2026. All seven categories are shown. These are planning scores for this site, not an independent rating or a comparison set.

Power
90
Water
70
Gas
90
Fiber
90
Land
75
ERCOT
60
Finance
90
Campus snapshot 2026-09-02 · overall 85 · power 90 · water 70 · gas 90 · fiber 90 · land 75 · ercot 60 · finance 90
Source: [3] · [7]
SITE ASSESSMENTP3 · SCORECARD20 / 25
Kerr County aerial terrain and conceptual campus context
Ascendent
ASCENDENT Kilo · Kerr County
DOC · KILO-SA
REV · 3.1 · 2026.09.16
CLASS · CONFIDENTIAL — SUBJECT TO CONTRACT
[P4]

From this campus to a scoped next step.

How we work with your team on this site.

The file is ready for a tenant conversation. Bring your requirements. We close the remaining workstreams with you — and we do not treat the study basis as power already in the building.

PROJECT KILOSITE ASSESSMENT21 / 25
Site context · aerial imagery / source terrain · conceptual overlays, not a survey. Imagery: Esri, Vantor, Earthstar Geographics & GIS User Community.
Ascendent
ASCENDENT
P2 · STORAGE
KILO-SA

A buffer between generation and the halls.

Containerized storage is the flexible-capacity story — not a committed megawatt-hour award.

Storage sits between generation and the halls so you can buffer and shape load. Blocks can land as the campus grows. This is how the site can work — we do not invent a storage award or a ready date.

SITE ASSESSMENTP2 — STORAGE22 / 25
Ascendent
ASCENDENT
P4 · §2 NEXT GATES
KILO-SA

The work we do with you.

Named workstreams. The full action list lives in the source annex.

These are the workstreams we run with a tenant — grid, fuel, title, corridor, water, fiber, and one governing schedule.

SITE ASSESSMENTP4 — ENGAGEMENT23 / 25
Ascendent
ASCENDENT
A · DOMAIN INDEX
KILO-SA
PROJECT KILO · SITE ASSESSMENTEVIDENCE INDEX24 / 25
Ascendent
ASCENDENT
[A] · GATES AND SOURCE DIFFERENCES
KILO-SA

We keep each source on its own terms.

Open workstreams and files that do not yet agree. Not a failure report.

When two files disagree, we show both. Use the campus brief with the originals, the variant register, and the remaining requests.

PREFERRED — Grid
2,100 MW / 345 kV requested study basis (kerr-domain-authoring.json · grid-02). [L1]
BUNDLE CLAIM
clm-kerr-power-01 uses "executed-IA" wording with 2,000 MW. Retain in annex. [L2]
PREFERRED — BTM
Authored Phase 1: 442 CAT G3520K engines / 1,105 MW (Kerr County Gantt). [L1]
SUPPORTING JSON
191 engines / 477.5 MW (kerr_ascendant_gen_mix_schedule.json). Separate record. [L5]
NOT CAMPUS MW
Oasis Pipeline implied ~1,293 MW is marked binding: false. Not campus capacity. [L6]
ACREAGE
Survey 3,979.63 ac · Phase I 4,005.86 ac · Appraisal 4,500-ac premise. Crosswalk open.
FINANCE
One layer noted appraisal as not in the reviewed file; the authored finance row cites a Colliers study on a 4,500-acre premise (no inspection, full-entitlement assumption). Annex only — we do not lead with that figure. [L1]
Source pin: 85ad9bfa (strataiq-frontend feature/kilo-improvements). Original PDFs not in this branch; titles reproduced from authored data only.
